Driveway Excavation in Derby, CT: Stop Patching, Start Rebuilding

Kash CochranePublished

  • driveway excavation
  • derby ct
  • base failure
  • driveway drainage
Driveway Excavation in Derby, CT: Stop Patching, Start Rebuilding

You have patched the same spot every spring for years. Cold patch, then hot patch, then a load of stone, then cold patch again. The crack comes back in the same place, the low spot gets a little lower each thaw, and after a heavy rain there is a channel where the water crosses. At some point the honest question stops being which product to buy and becomes why this keeps happening. It almost always keeps happening because the problem is not on the surface. On a short, steep Derby driveway, the base, the drainage path, and the subgrade decide whether a resurface holds or fails again by next winter, and none of them are visible from the top.

Key Takeaways

Recurring failure is a drainage and subgrade question

settlement or washout that returns in the same place after every thaw is a reason to investigate what is under the surface before buying another surface.

Excavation here is diagnostic, not cosmetic

exposing enough area to find the cause is what separates a rebuild that lasts from a resurface that repeats the failure.

Derby treats driveway runoff as a real issue

the City's stormwater guidance says runoff from hard surfaces including driveways reaches storm drains and then rivers and ponds, and names soil from unpaved driveways as a pollutant source.

Private driveway and public way work are different approval paths

Derby Ordinance 172 requires a street opening permit for work in a public street, highway, or right of way, and a state highway also has a CTDOT encroachment path. Neither automatically applies to work entirely on your own property.

811 applies to homeowners too

the notification requirement covers a homeowner using power operated equipment, not only contractors.

Recurring Settlement Means the Base or the Water Is Failing

There is a useful distinction between an isolated defect and a pattern. A single crack from a frost cycle, a scuffed corner, a spot where a delivery truck sat, those are surface events. What you are describing is different: the same location, every year, getting slightly worse.

That pattern points at one of two things, and usually both. Either the base has lost support, so the surface above it is spanning a void and cracking under load, or water is crossing or sitting where it should not be, softening the subgrade and taking the fines with it. Adding stone or asphalt over either of those buys a season.

The investigation questions are concrete. Where does runoff enter the driveway and where does it leave? Does the failure follow a thaw, a heavy rain, or both? Is the defect isolated or broad? Has the surface lost support, or is it just worn? Do the existing grades send water toward the house, toward a neighbor, or toward a storm drain? On a steep approach, does the water run down the driveway itself because there is nowhere else for it to go?

Matching the Symptom to the Next Step
What you are seeingOne isolated crack or a worn surface, no settlement
What it usually points atSurface wear
Likely scopeSurface repair may be appropriate, once base and drainage are ruled out
What to check firstWhether the defect moves or grows between seasons
What you are seeingBroad depressions, a spot that sinks a little more each year
What it usually points atLoss of base support
Likely scopeExpose the base to find the cause before choosing a surface
What to check firstWhether water reaches that spot, and what the subgrade looks like under it
What you are seeingWashout, channels, loss of fines after heavy rain
What it usually points atWater crossing or running along the driveway
Likely scopeCorrect the water path first, then rebuild what it damaged
What to check firstWhere the runoff enters, and whether there is an outlet
What you are seeingSoft or pumping surface after a thaw
What it usually points atSaturated or unsuitable subgrade
Likely scopeDrainage and subgrade correction, not more stone on top
What to check firstWhether groundwater or trapped water is the source

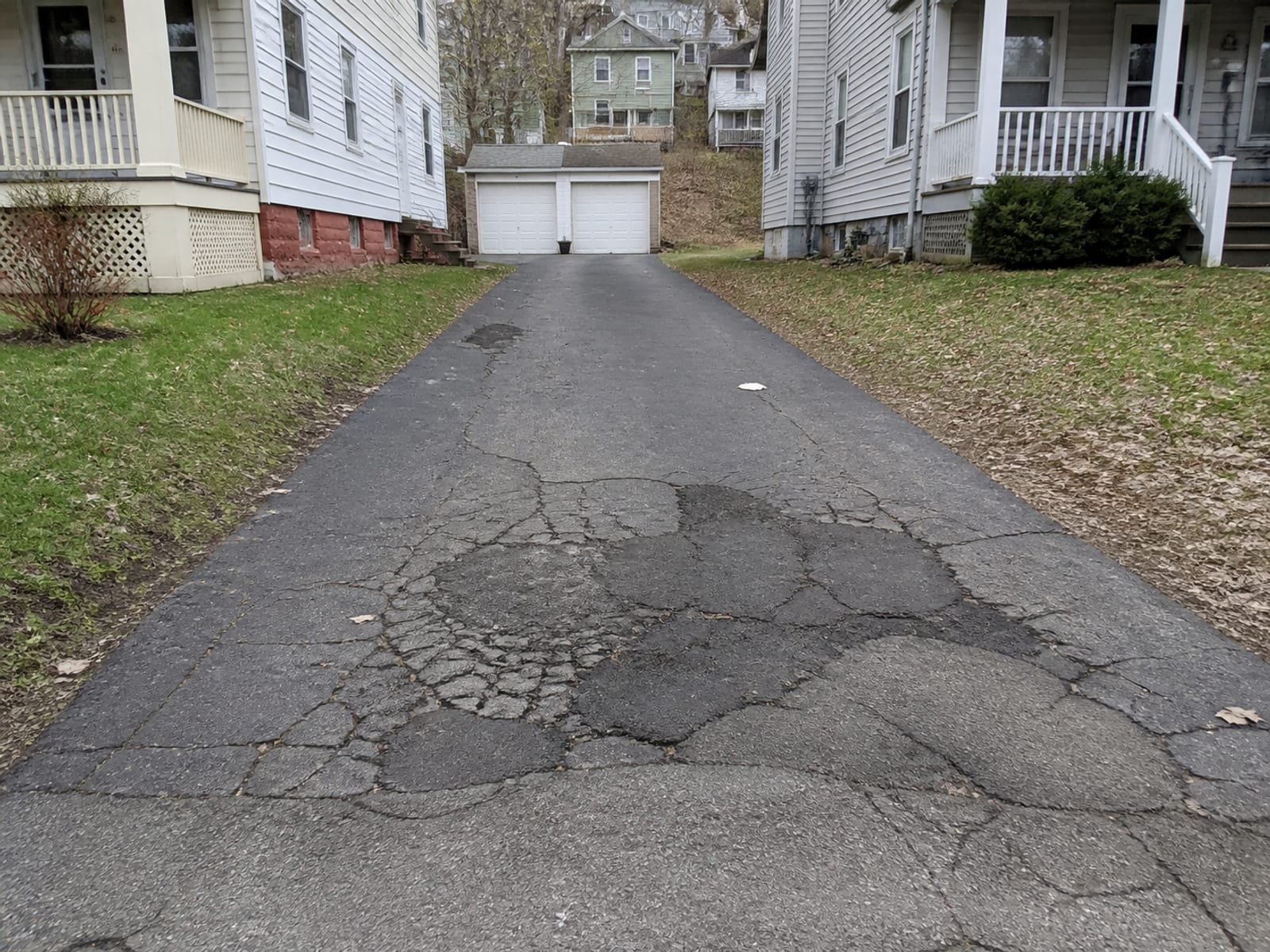

Residential asphalt driveway with a settled depression and cracking concentrated in one area, showing repeated patch repairs over the same spot
A defect that returns to the same place every spring is describing the base, not the surface.

Water Is the Variable Most Driveway Quotes Skip

Derby sits in the Housatonic River watershed, and the City's own public guidance is explicit that runoff from hard surfaces including driveways reaches storm drains and travels on to rivers and ponds. It also identifies soil from unpaved driveways and construction sites as a pollutant source. That is a legitimate reason to look past the top layer rather than a bit of environmental garnish: a driveway that is losing material is losing it somewhere.

The City's Plan of Conservation and Development maps alluvial and floodplain soils, poorly drained and very poorly drained soils, floodway, and 100 year and 500 year flood zones along the river corridors. On a compact, low lying, or river adjacent property, the driveway's runoff route, its outlet, and any disturbed soil deserve the same attention as the pavement itself. That is a reason to check your parcel, not a finding about it.

Derby's zoning rules also show that the City treats driveway grade and runoff as design questions when the scope triggers that section. For flag lot access strips, the regulations cap grade at 10 percent, and at 3 percent within 25 feet of the street intersection, require a 15 foot paved access strip, and prohibit stormwater discharge onto adjacent properties. Those are flag lot provisions rather than universal rules for every existing driveway, but they make the point: grade, access, and where the water goes are treated as site design matters, not afterthoughts.

Six Things Set the Scope, and the Price Follows Them

No official Derby or Connecticut source publishes a defensible homeowner price range for driveway excavation or replacement, so a figure quoted before someone has looked at the base is invented. What a real quote should separate out:

Drainage, runoff, and where the water actually goes

Whether the fix needs a swale, an inlet, pipe, an outlet, edge containment, or simply corrected cross slope. This is the item most often missing from a cheap quote and most often the reason the cheap quote fails.

Excavation depth, unstable subgrade, rock, and disposal

How far down the failure goes is discovered, not assumed. Unsuitable soil, ledge, or saturated ground each change the method and the hauling.

Access, slope, staging, and material delivery

A steep approach and a tight lot change what equipment can work and where material can sit. Delivery access affects the sequence as much as the price.

Aggregate base, compaction, and the surface choice

The base is the part that carries the load. Compaction in controlled lifts is what makes it a base rather than loose stone, and the surface choice sits on top of that decision rather than replacing it.

Utilities and the 811 process

Connecticut requires the notification before power operated excavation, at least two full days ahead excluding Saturdays, Sundays, and holidays, and no more than 30 days ahead. That applies to a homeowner using powered equipment, and where a contractor is hired, the contractor performing the excavation makes the notification.

Permits, wetlands, and whether the work reaches the public way

Which of these applies depends entirely on where the work limits fall, which is worth settling before anyone quotes.

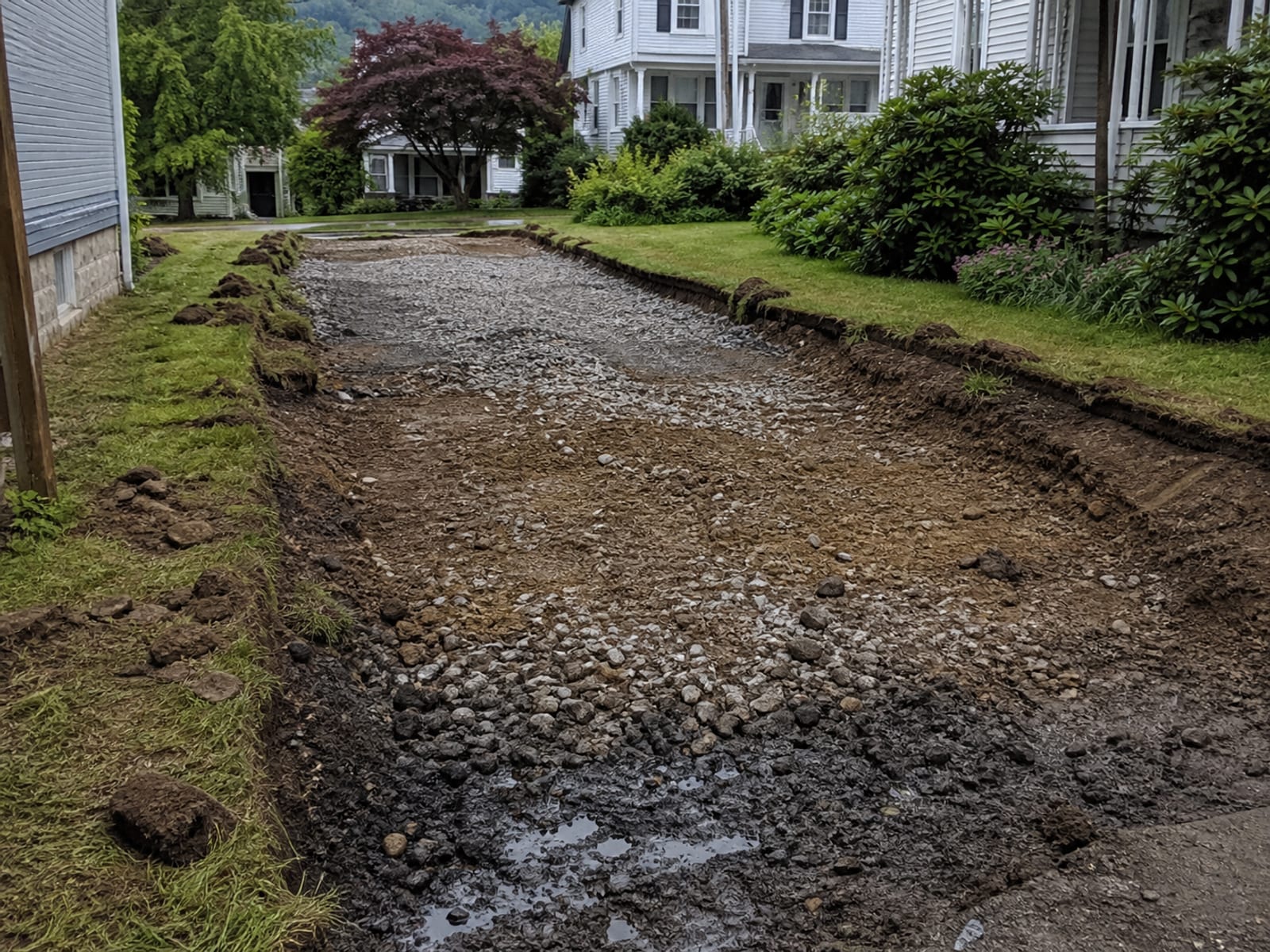

Driveway excavation with the surface removed and the aggregate base and subgrade exposed, showing soft saturated material at one end of the cut
Excavation here is diagnostic. Enough area gets opened to find why the surface kept failing.

Private Driveway Work and Public Way Work Are Not the Same Project

This distinction is worth being precise about, because conflating the two misleads people in both directions.

Work entirely on your own property, replacing a driveway more or less like for like, did not turn up a universal Derby permit requirement in the sources reviewed. That is not the same as saying no permit applies to your project. Confirm the address and the scope with Derby Planning and Zoning before scheduling.

Work in a Derby public street, highway, sidewalk, curb, or public right of way is different. Derby Ordinance 172 requires a street opening permit from the Street Commissioner or designated agent before opening, excavation, driveway construction, or other construction work there. The ordinance also states that the City street opening permit is required before CTDOT issues its permit for a state highway within Derby. CTDOT separately describes its encroachment permit as covering use of state highway right of way, including driveway curb cuts and excavations.

So the apron where your driveway meets the road can put you in a different process from the rest of the same job. Establishing where the work limits actually fall is a scoping question, not a formality.

Approval Paths by Where the Work Falls
TriggerPowered excavation anywhere on the property
What is neededCBYD notice at least two full days ahead of non emergency work, excluding weekends and holidays
Who administers itCall Before You Dig, overseen by Connecticut PURA
TriggerWork in a Derby public street, highway, or right of way, including driveway construction there
What is neededCity street opening permit before work
Who administers itDerby Street Commissioner or designated agent, under Ordinance 172
TriggerWork in a state highway right of way, including a curb cut or excavation
What is neededCTDOT encroachment permit, with the Derby permit first under the City ordinance
Who administers itConnecticut Department of Transportation
TriggerRegulated wetland or watercourse activity
What is neededAddress screening and filing where a regulated activity is proposed
Who administers itDerby Inland Wetlands Agency and Wetlands Enforcement Officer
TriggerPrivate construction disturbing one acre or more
What is neededConstruction stormwater authorization path, and a Stormwater Pollution Control Plan as applicable
Who administers itDerby local review, and CT DEEP for stated five acre or more private projects

New Gravel Does Not Fix a Failing Subgrade

Gravel is a legitimate surface with real advantages on a rural or semi rural drive, and it is often the right answer. What it is not is a remedy for saturated or failing ground underneath.

Regrading and adding new aggregate makes sense where the problem is the surface itself: lost crown or cross slope, fines washed out, erosion at the edges, no edge containment. Those are maintenance issues on a functioning base, and correcting the shape so water sheds rather than runs down the middle is most of the fix.

Where the subgrade is soft, saturated, or unstable, new stone placed on top disappears into it. The fines migrate, the surface pumps under load, and within a season you are back where you started with a larger bill. The order has to be: understand the water, correct the subgrade, then build the base, then choose the surface.

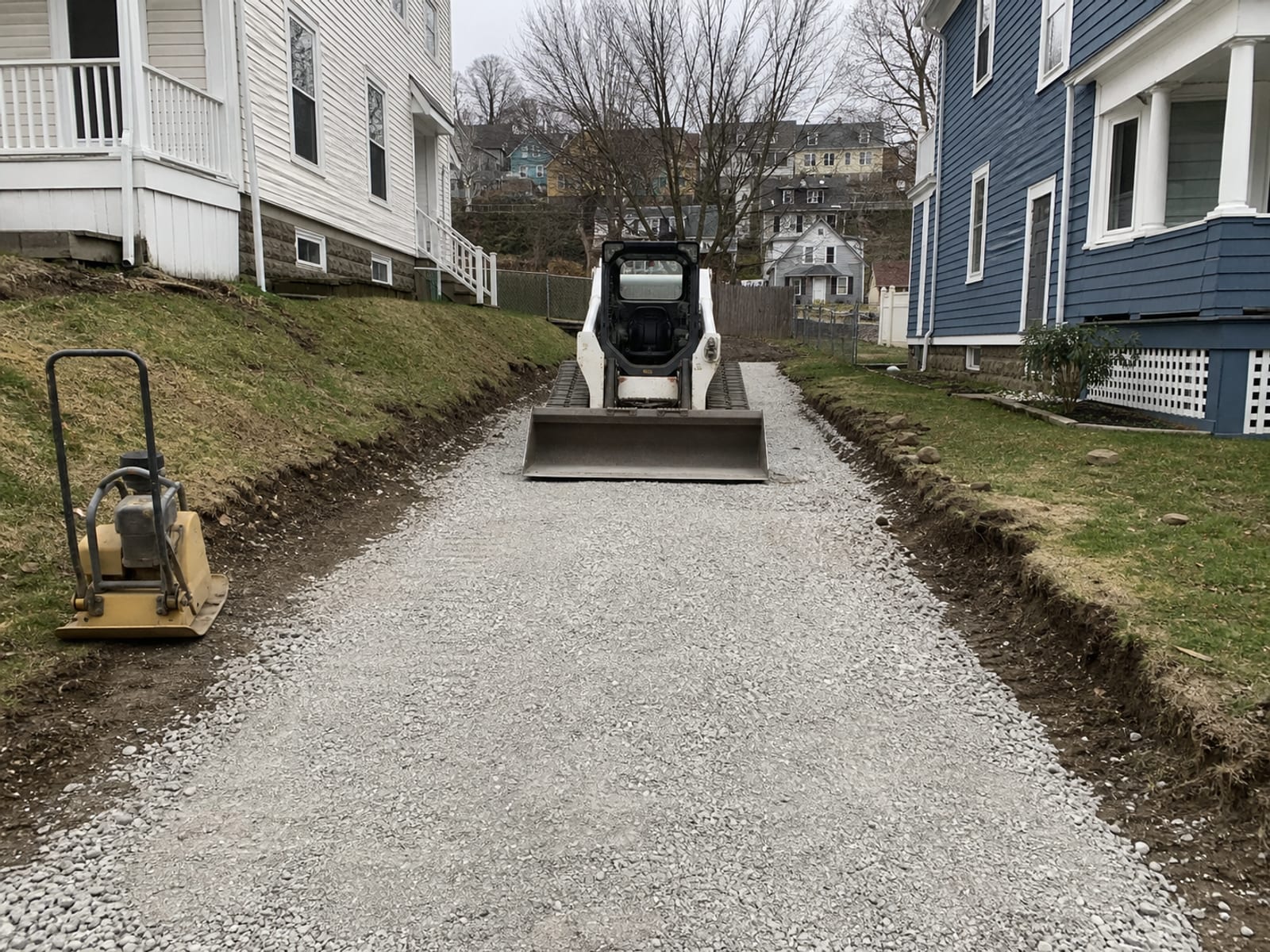

Compacted aggregate base placed along a residential driveway with a plate compactor and a compact loader parked at the open end of the run
The base is built in controlled lifts and compacted. That layer, not the surface, is what carries the load.

What a Real Driveway Excavation Job Looks Like

Site Walk to Final Water Check
StageSite walk, drainage diagnosis, approvals screen
What happensWhere runoff enters and leaves, whether the failure is isolated or broad, existing grades, whether the work reaches curb, sidewalk, road, or a regulated area
Stage811 notice and utility response
What happensFiled with the required lead time, marks preserved and worked to, private lines identified separately
StageAccess, staging, and erosion control setup
What happensTruck route, material drop, spoil location, and controls in place before the surface comes up
StageRemoval, excavation, and subgrade inspection
What happensEnough area exposed to find the actual cause, with unsuitable material identified rather than buried
StageDrainage installation and grading
What happensThe water path corrected first, with a real outlet, so the new structure is not built into the same problem
StageAggregate placement and compaction
What happensBase built in controlled lifts and compacted, because that is what carries the load
StageSurface, restoration, and a final water check
What happensSurface installed to the material's requirements, disturbed areas restored, and performance confirmed with water actually running

No publicly sourced completion duration for a private Derby driveway excavation exists either, so a promised number of days before a site visit is a guess. Access, quantity, weather, material delivery, utility markouts, and any approval path all set the schedule.

Five Mistakes That Guarantee You Patch It Again

  • Patching the surface before finding the water path. This is the loop you are already in.
  • Skipping 811, or assuming a private lot has nothing buried. Services, old drains, and irrigation all live under driveways.
  • Adding stone over saturated soil. Without separation, drainage, or a subgrade fix, the stone goes into the ground and the problem stays.
  • Sending runoff toward the house, a neighbor, a storm drain, a wetland, or a watercourse without review. Moving a problem is not solving it, and in Derby it can be a regulated matter.
  • Treating curb, sidewalk, or right of way work as ordinary private driveway work. Different process, different authority, and finding out late is expensive.

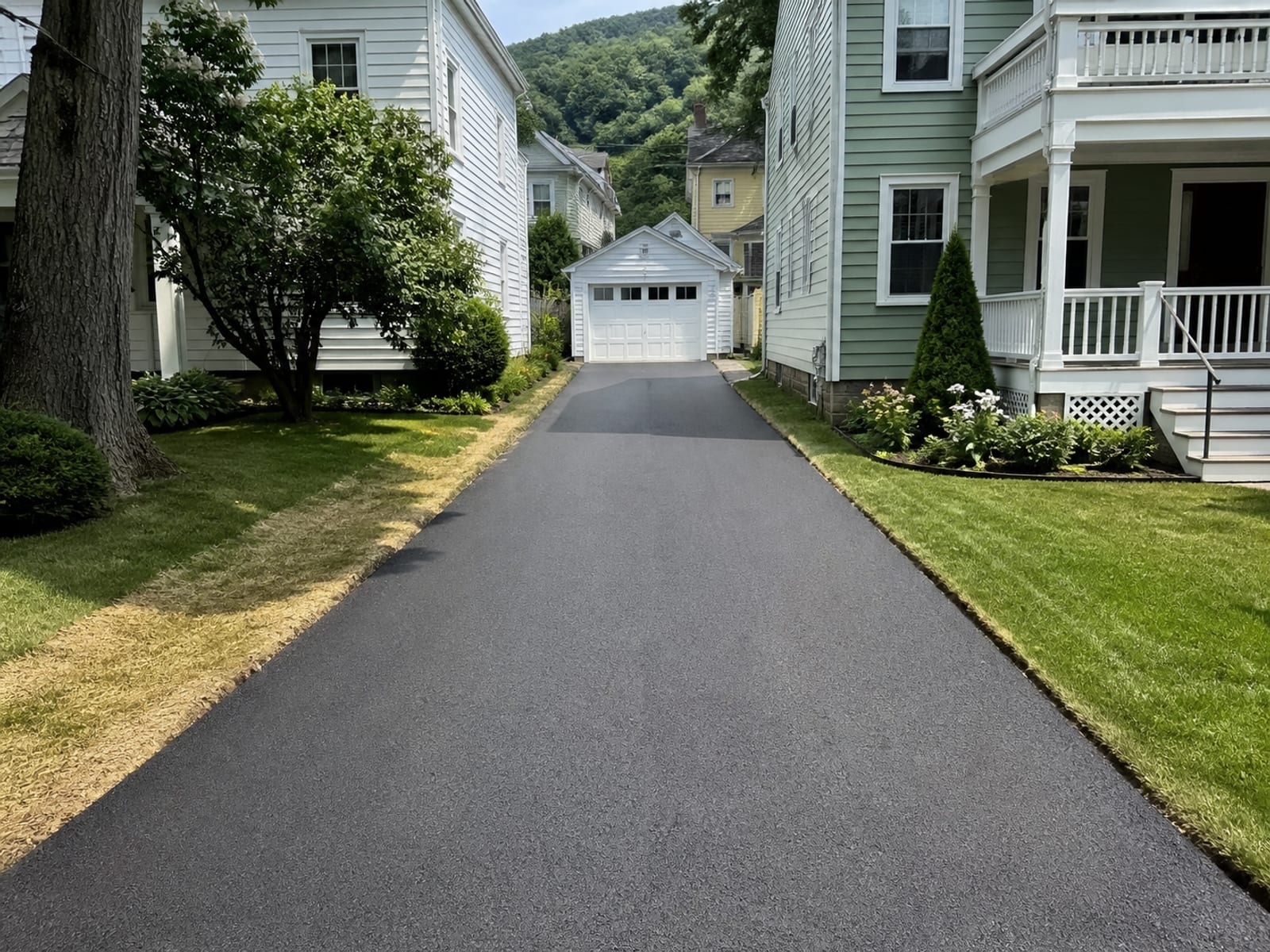

Completed residential driveway with an even crown and cross slope shedding water to both edges, and restored ground along the sides
Shape is part of the fix. A driveway with proper crown sheds water instead of channelling it down the middle.

Use This Checklist Before You Call Anyone

Does water cross the driveway, or run along it? Is the defect isolated or broad? Does it recur after a thaw, after heavy rain, or both? Is there a steep approach or tight truck access? Is the driveway near a watercourse or a visibly wet area? Does the work touch curb, sidewalk, road, or a state route? Are the utility marks complete and current?

The answers point at the next step rather than the solution. Several yeses on drainage and recurrence mean a contractor site visit with the base exposed. Anything touching the public way means a municipal screening conversation first. Active erosion carrying material off the property is the one that should not wait.

Hire It Out at Powered Excavation

The line sits at machine work and anything structural or regulated: powered excavation, utility exposure, drainage structures, major regrading, steep sites, and public way or regulated area work.

Before work starts, a contractor should be able to tell you the planned drainage route and where the water will end up, the base and compaction approach, how spoil and material will be handled, and who is responsible for which permit. If the proposal is a surface price with no mention of the base, no drainage detail, and no named outlet, it is a quote to repeat the failure at a competitive rate. Prestige Property Maintenance works out of Oxford and serves Derby rather than from a Derby yard, which matters for how access and material delivery get planned.

Is It the Surface or the Base?

1. The same spot on your driveway settles a little more every spring. What does that suggest?

2. Your driveway washes out after heavy rain. What comes first?

3. Does an 811 notice apply if you do the digging yourself?

4. Your driveway apron meets a Derby public street. What changes?

Pick an answer to begin.

Frequently Asked Questions About driveway excavation derby ct

What is the typical price range for driveway excavation in Derby, CT? No official Derby or Connecticut source publishes a defensible range, so a number offered before an on site scope is not based on anything. A real quote separates mobilization and access, demolition and disposal, excavation depth, imported aggregate, drainage components, ledge or unsuitable soil handling, compaction, surface material, restoration, permits, and any engineering or wetland work. That itemization is what lets you compare two proposals honestly.

How do I know whether driveway replacement is better than another patch? Repeated settlement, washout, or drainage failure in the same place is the signal. A patch is reasonable for an isolated defect on a sound base. Once the pattern repeats seasonally, the base and the water path need investigating, because another surface layer is being asked to bridge a problem underneath it.

Can a gravel driveway fix a washed out driveway? Only after the water path and the subgrade are addressed. New gravel on a functioning base with corrected shape and drainage works well. New gravel over saturated or unstable ground migrates into it, and the washout returns.

Do I need to call 811 for driveway work in Derby? Yes, for excavation using power operated equipment. Connecticut requires the advance CBYD notice, and the requirement applies to a homeowner using powered equipment as well as to a contractor. Where you hire a contractor, the contractor performing the excavation makes the notification.

When does roadway excavation in Derby need a permit? Work in a Derby public street, highway, or public right of way requires a City street opening permit under Ordinance 172, which covers opening, excavation, driveway construction, and other construction work there. Work in a state highway right of way has a CTDOT encroachment path, and the City ordinance states the Derby permit comes before CTDOT issues its permit.

Do wetlands or a watercourse change a driveway project? They can. Contact Derby's Inland Wetlands Agency for address specific screening before disturbance. Proximity on a map is not a final regulated area determination, and the Agency makes that call rather than the contractor.

What time of year is best for driveway excavation? No universal Derby seasonal schedule exists. Plan around groundwater, freeze thaw, wet soil, erosion control, approval lead time, and whatever the surface material's own requirements are for placement temperature and conditions. Those constraints are real but they are scheduling inputs rather than a closed season.

Driveway Terms Worth Knowing

Tap a term to see what it means.

Subgrade. The natural ground beneath the base. If it is soft, saturated, or unsuitable, everything built on it inherits the problem.

What This Means for You

You already suspected the surface was not the problem, and the pattern you are describing supports that. A defect that returns in the same place after every thaw, or a channel that reappears after every heavy rain, is telling you about the base and the water rather than the top layer. That is genuinely good news, because it means there is something to fix rather than an annual maintenance tax.

The order that works is unglamorous: find where the water comes from and where it can go, expose enough of the failure to see the actual cause, correct the drainage, rebuild the base properly with compaction that means something, and only then choose a surface. Skipping to the surface is what has cost you the last several springs.

If your Derby driveway keeps failing in the same spot, Prestige Property Maintenance will look at the water and the base rather than quoting a resurface. We handle driveway and roadway excavation along with the drainage solutions, grading, and paving prep that usually have to happen with it, with one crew out of Oxford across the Naugatuck Valley. Call us at (203) 258-3395 or contact us and we will tell you whether this is a repair, a drainage correction, or a rebuild, with the reasoning behind it.
